|
Initial construction of the Yum Yum Palace began in late winter/early
spring 1974 with the clearing and leveling of the site. Great care was taken
to keep as many of the grown trees in place around the building. |
|
|
|
|
|
|

To pour the concrete foundation for the massive building, forms were

placed and concrete was pumped in with a long boomed pumper truck to
reach all of the areas from the clearings around the site. To help

the concrete cure properly, the foundation walls were topped with straw
in an effort to protect it from freezing.
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|
|

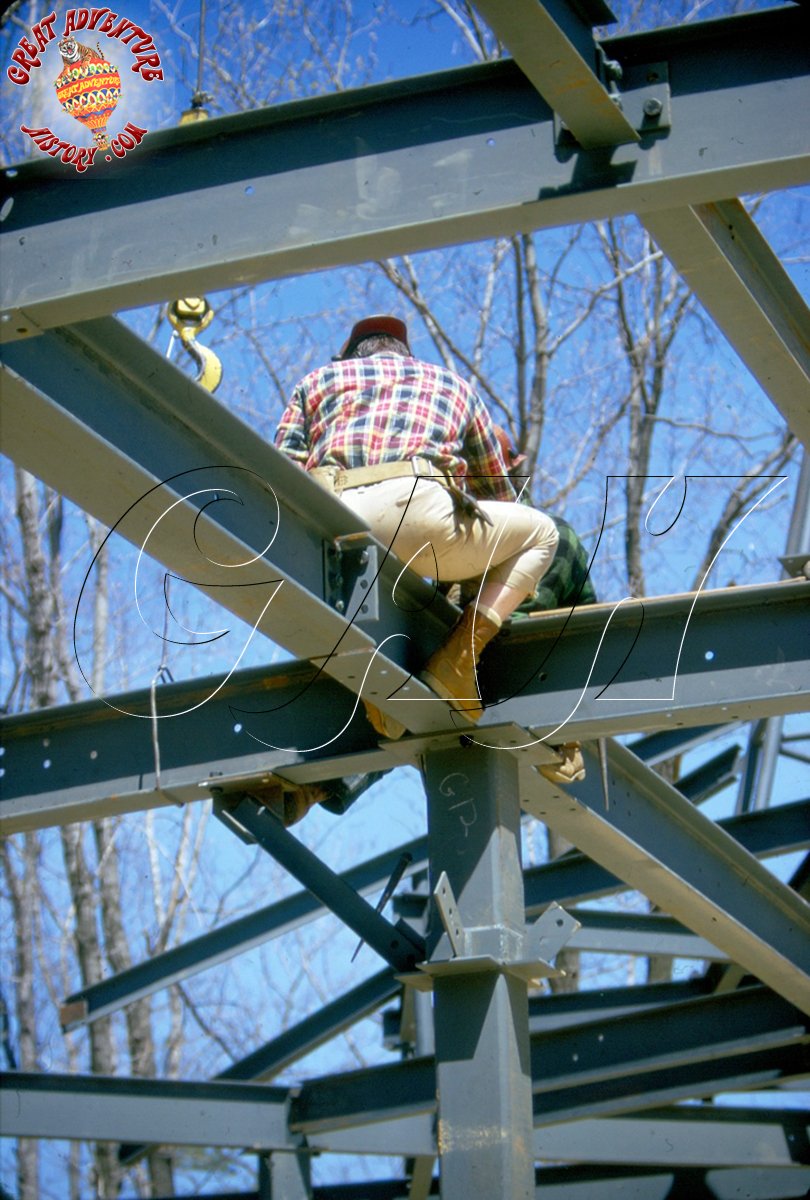

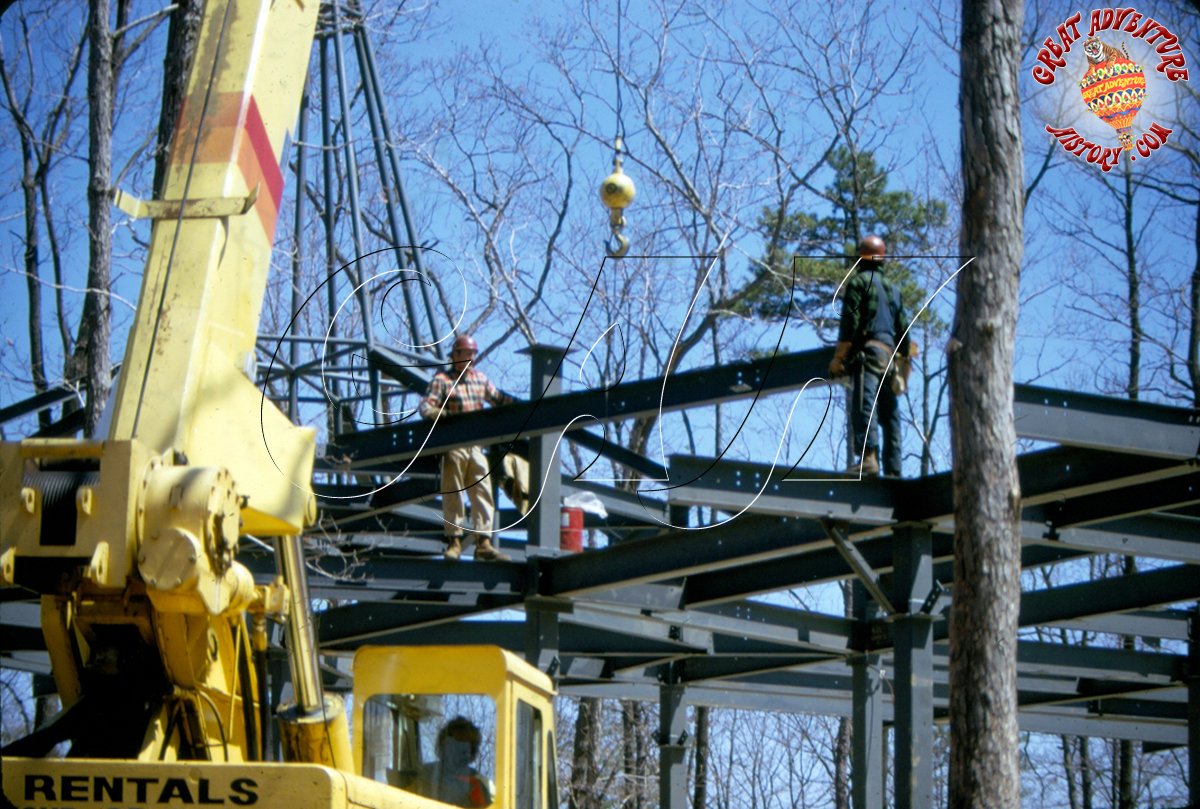

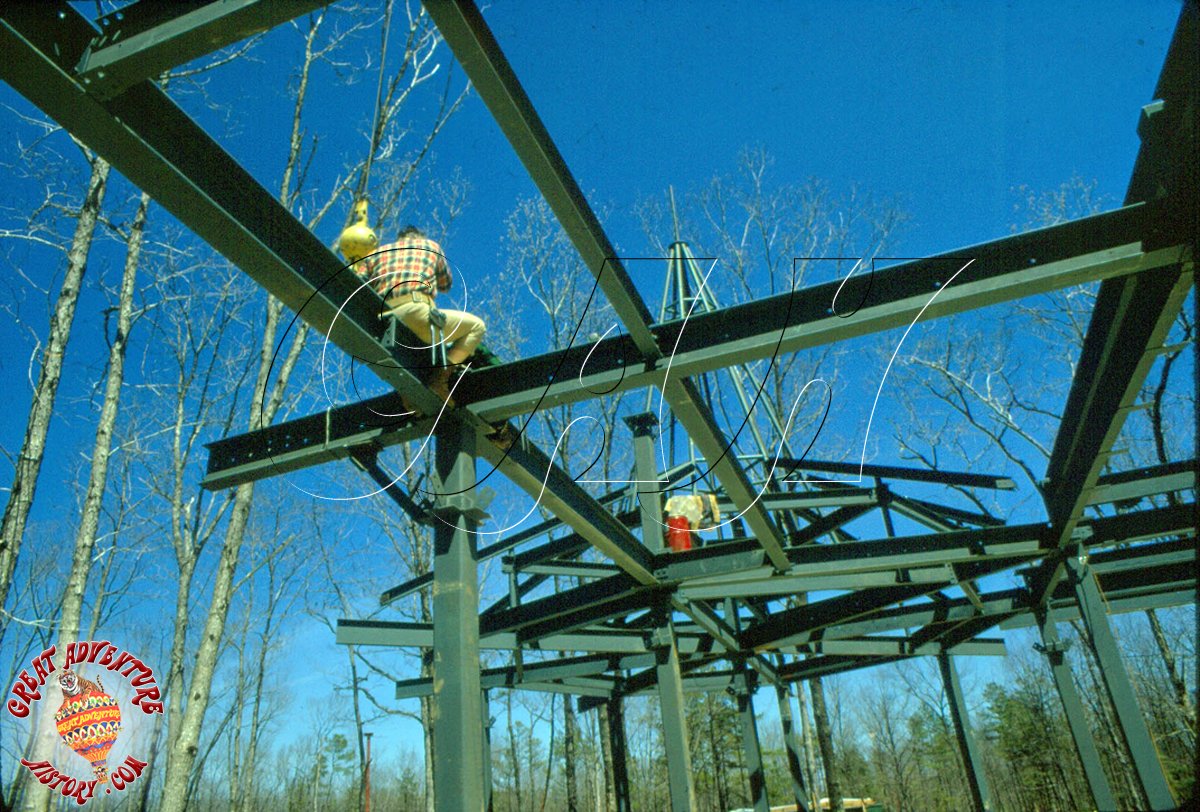

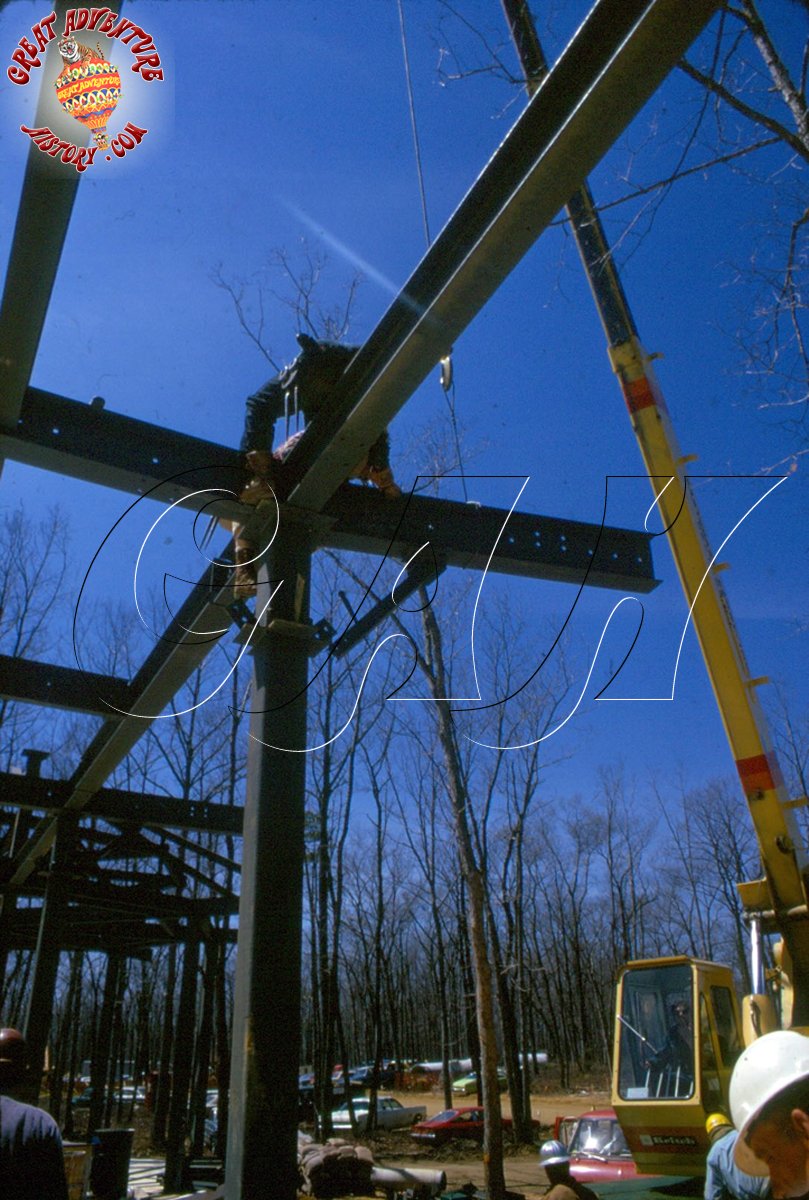

With the concrete foundation in place the steel framework started going
up. The building's basic rectangular box shape was the easy part, but
the unique webs of steel at each corner needed to make the round and
sloped roofs were much more intricate. The steel framework would
eventually be well hidden by the building's decorative elements. |
|
|
|
|
|
|
|
|
|
|
|
|
As the steel girder frame was completed, smaller and more intricate
steel frames were applied to the round edges. These steel frames would
eventually support all the fiberglass pieces which made up the colorful
ice cream and candy designs.
At the rear
of the restaurant, the kitchen area was constructed of concrete block
walls. Once finished the building would look unified with the decorative
fiberglass parts in place. |
|
|
|
|
|
|
|
|
|
|
|

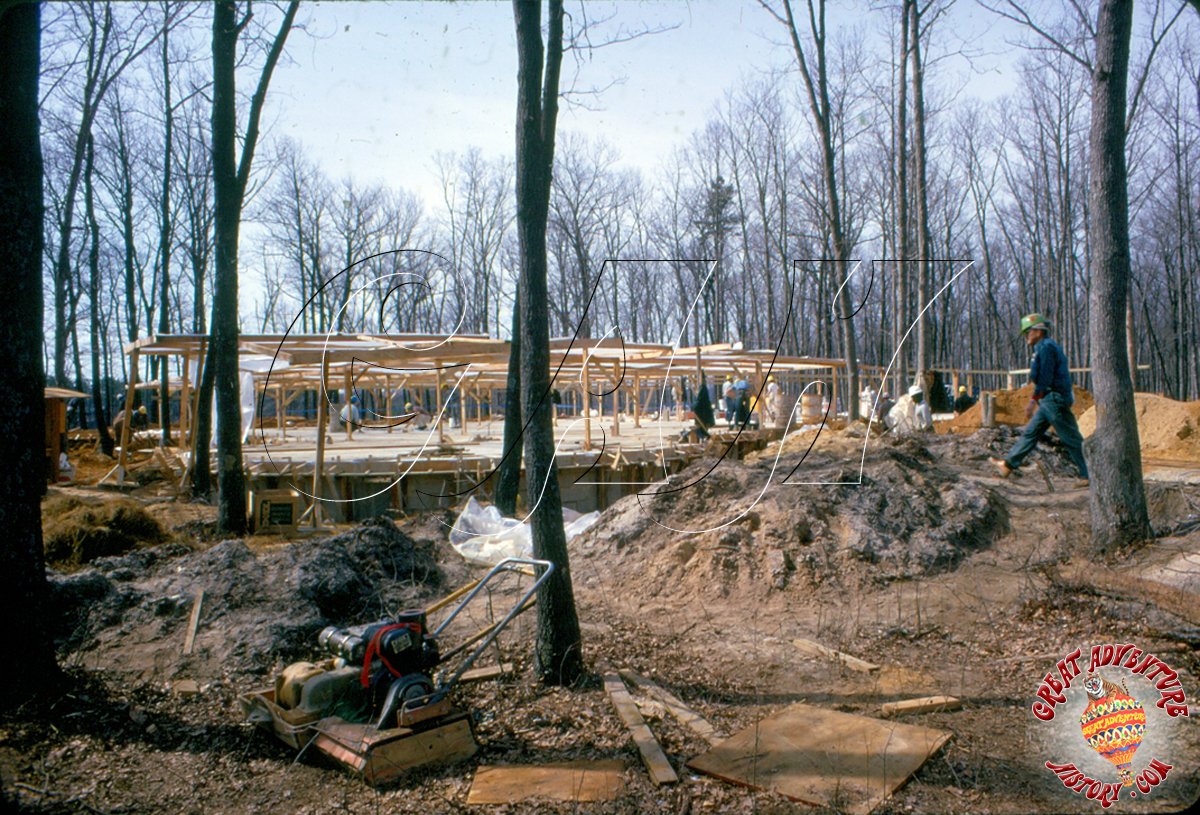

Once the steel framing was complete, the carpenters set to work creating
the plywood ceilings and framing out the windows and doors to enclose
the structure.
While construction was taking place in
the park on the building, the fiberglass decorative elements were being
fabricated and painted off site. |
|
|
|
|
|
|
|
|
|
|
|

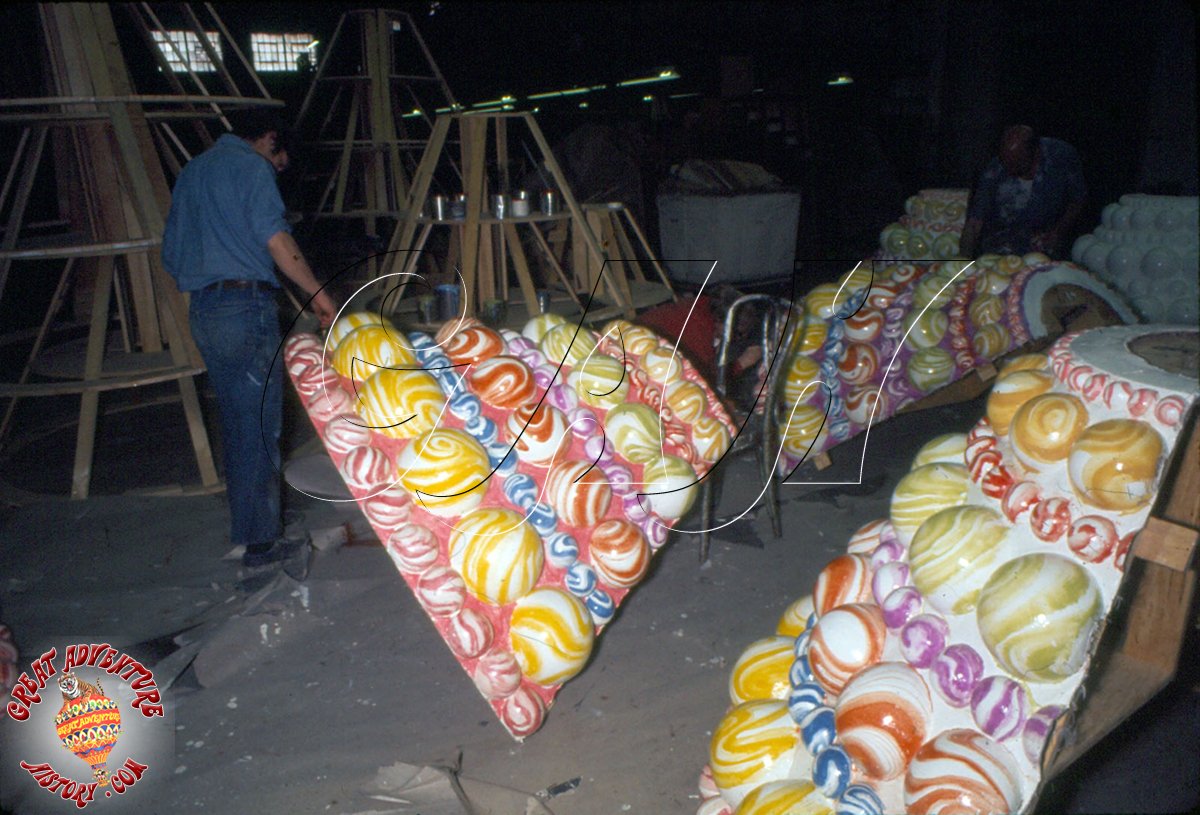

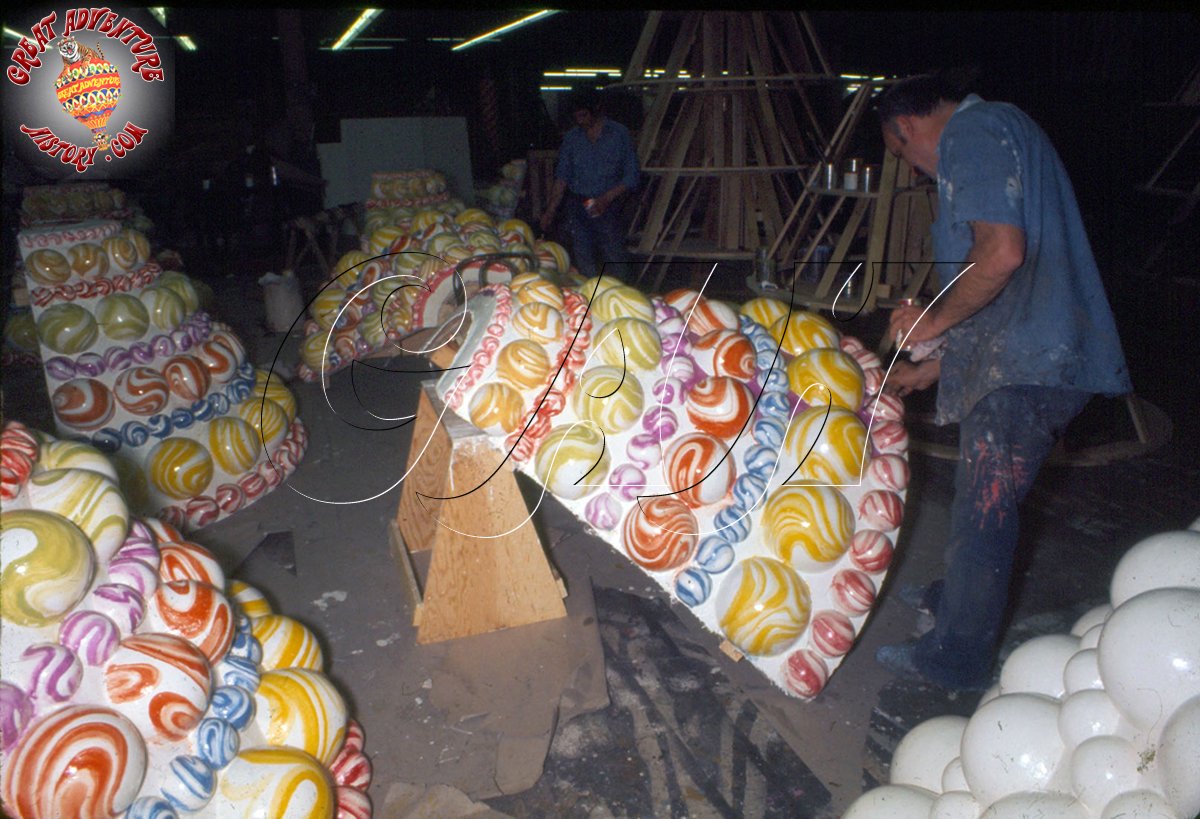

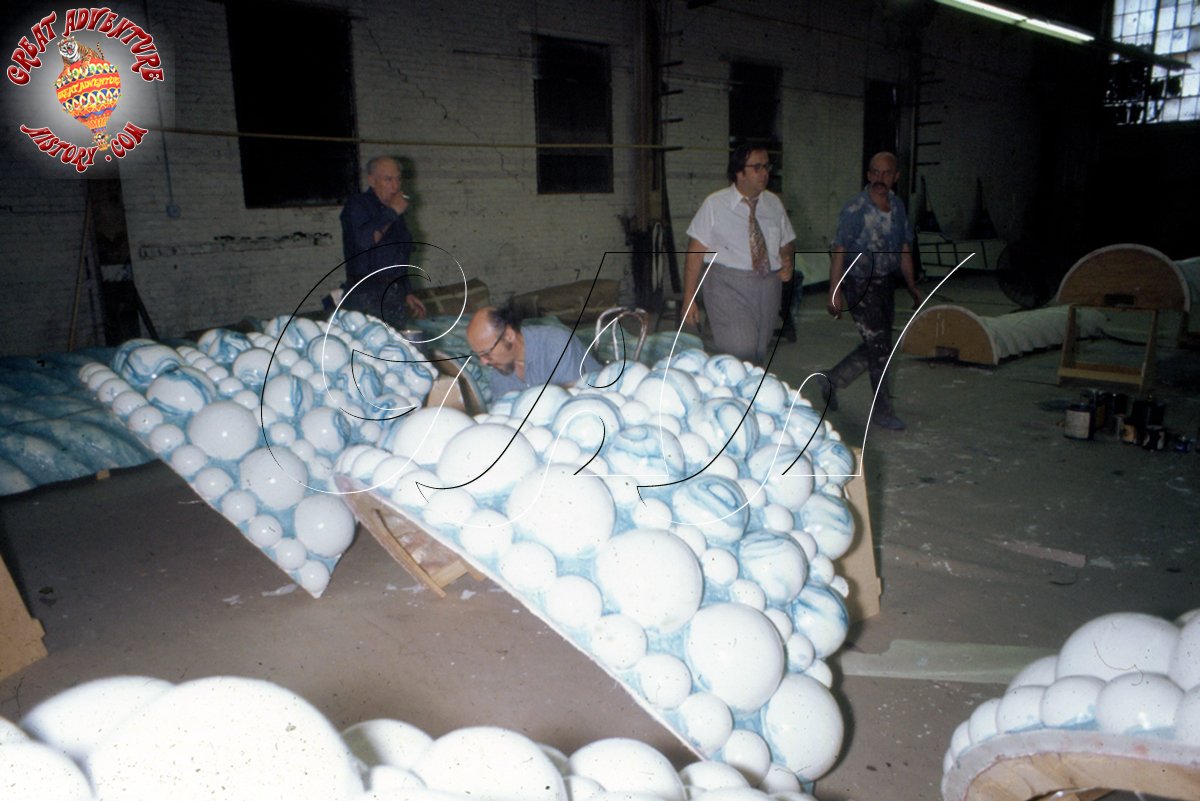

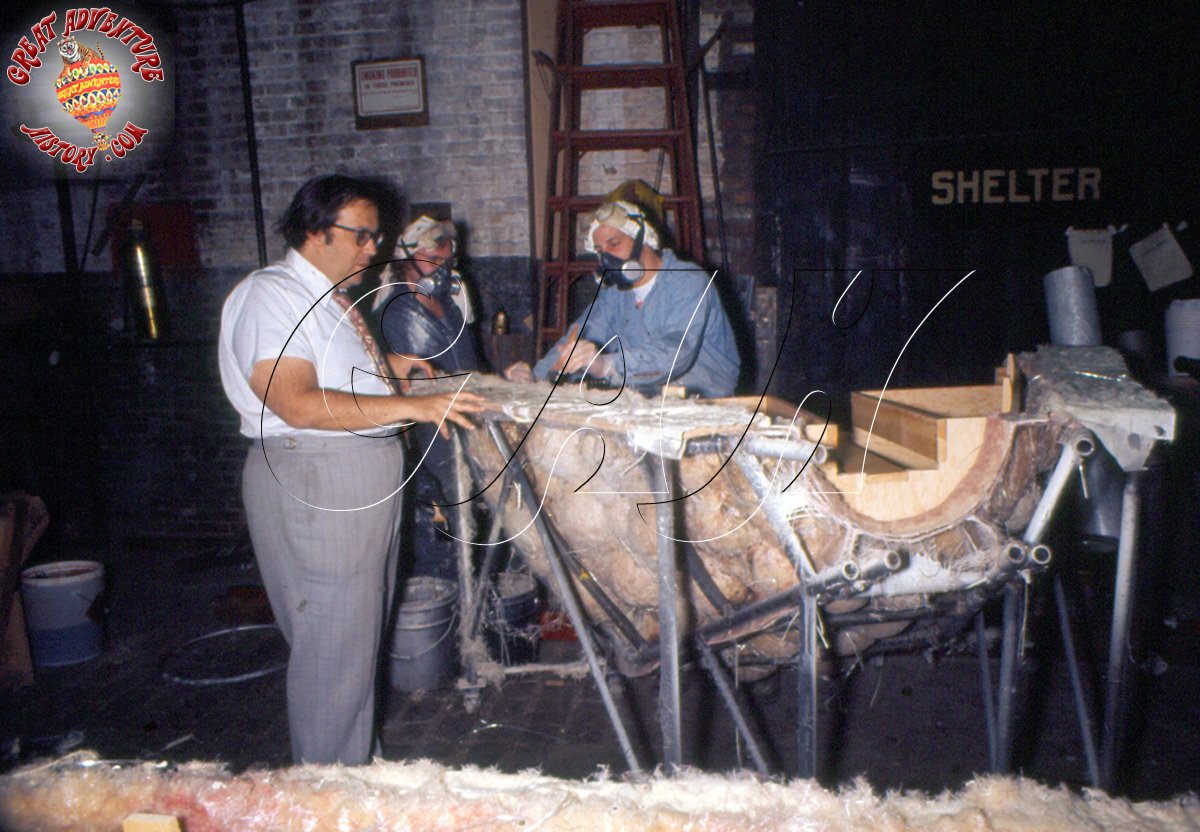

In a studio/warehouse, the columns and other decorative parts were molded

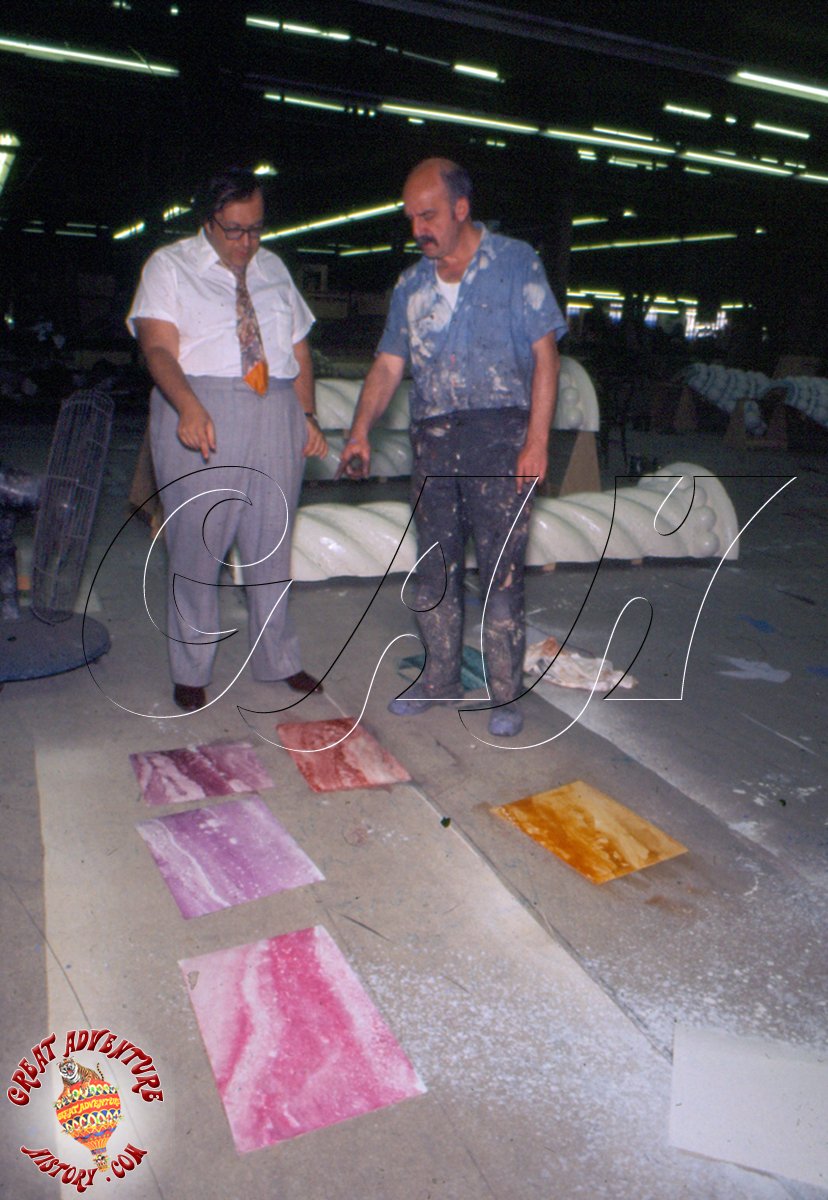

in fiberglass then painted. These pictures show Warner LeRoy overseeing
the process and choosing the colors and elaborate paint finishes before
the crew applied them. The intricate candy color marble swirl finish on the
tops of the columns must have been a time consuming process. |
|
|
|
|
|
|
|
|

The finished product of the candy buttons on the column tops was nothing
short of spectacular. To see the hundreds of balls on the columns and
see that each was unique gives some idea of the hundreds of man hours
that must have been required to paint all the decorative pieces for the
entire building. |
|
|
|
|
|
|
|
|
|
|
|
|

The spiral bases of the columns were equally colorful. The artists did
an amazing job of making the fiberglass look edible.

The
column tops and bases were married together and carefully wrapped in
plastic for their journey down to the park for installation. |
|
|
|
|
|
|
|
|
|

With the ceilings stuccoed and the terrazzo floors completed, the
columns were assembled, with the two halves covering the steel I-beams.
The two halves were sealed together with the tops of the columns against
the ceiling. The bases of the columns were left open for a separate
fiberglass ring to be applied later. |
|
|
|
|
|
|
|
|
|
|

Work was taking place all over the building simultaneously. While
insulation was going into the ceiling, the porch columns were looking
nearly complete. The seams between the two halves would get a
finishing coat of fiberglass filler and then the artists would touch up
the paint making them look like they were one solid piece. |
|
|
|
|
|
|
|
|
|
|
|
|

With the work progressing on the inside, work began on the elaborate top

of the building forming the giant sundaes. Once again, the
fiberglass was fabricated off site and trucked in. The edge of the

roof was trimmed with a decorative trim and a steel arch was placed
between the sundae scoops on the front of the building to support the
array of cones and scoops. Arches were planned for the two
sides of the building as well as between the front and back sundaes but
were never put in placed though the supports still stick out of the
restaurant's roof. |
|
|
|
|
|
|

Some of the final pieces to be installed were the twists on the archway.
These were equally as colorful as the rest of the building, each one in
its own unique color scheme or "flavor". |
|
|
|
|
|
|
|
|
|
|
|
As spring turned into summer and the park's July 1st opening day drew
near, all the elements started to come together, with all the final
details being added to the Yum Yum Palace. |
|
|
|
|
|
|
|
|
Nothing about the Yum Yum Palace was "regular" work for the crews
involved. Creating such a fanciful structure had to have been a once in
a lifetime experience and created unexpected challenges not found on
most everyday construction projects. Considering the short timeline in
which the building was completed, the crew did an amazing job. |
|
|
|
|
|
|

The sundaes would have additional decorations applied to the big central
vanilla scoops, and the roof edge trim would get dollops of whipped
cream applied to the white circles.

Once construction was
wrapping up and opening day was close, the landscaping crews arrived to
plant grass and new trees and bushes around the building. Warner LeRoy's
vision was that the Yum Yum Palace like most of Great Adventure's
attractions would be hidden by the trees of "The Enchanted Forest" and
then be a breathtaking sight when guests arrived at his larger-than-life
creations.
|
|
|
|
|
|
|
|
|
|
|
